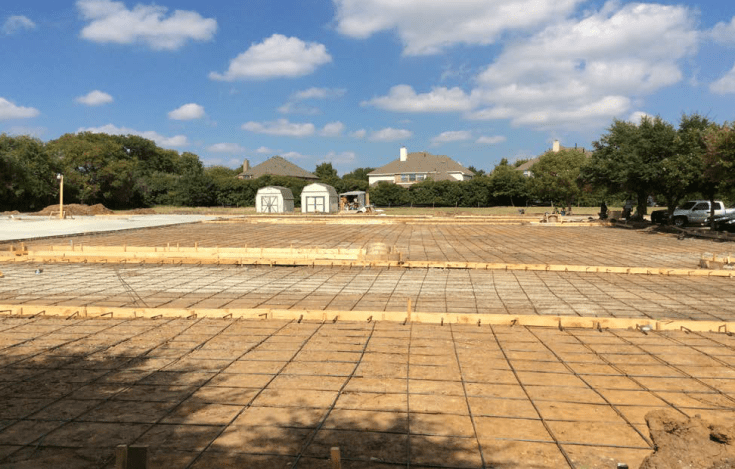

1. SITE CIVIL WORK

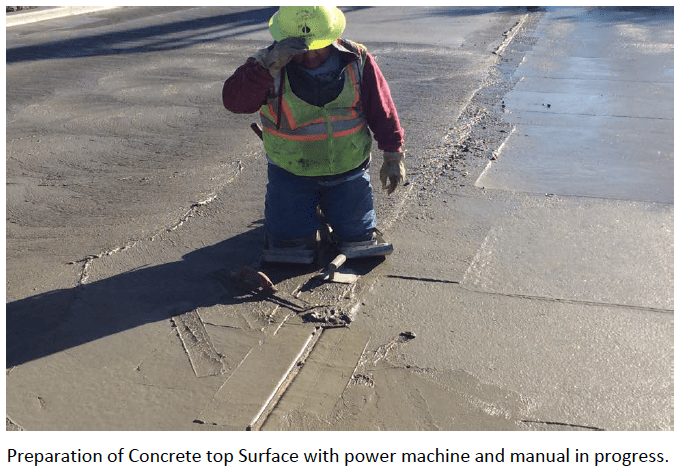

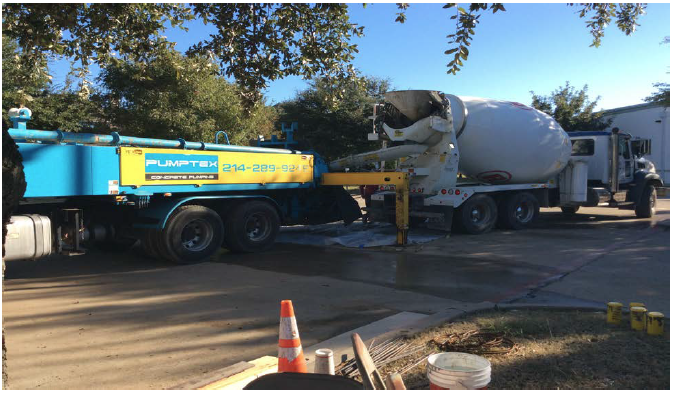

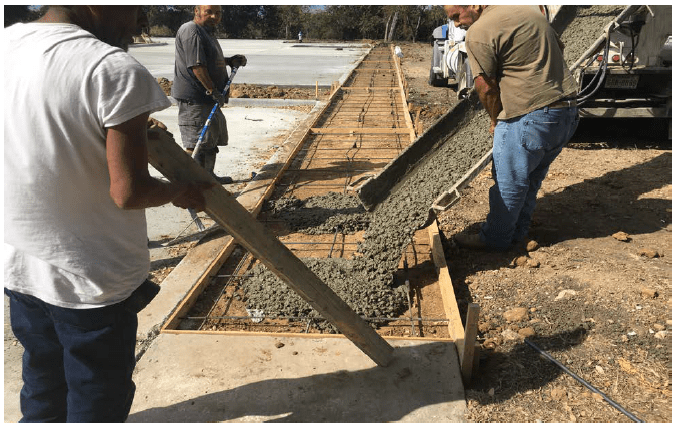

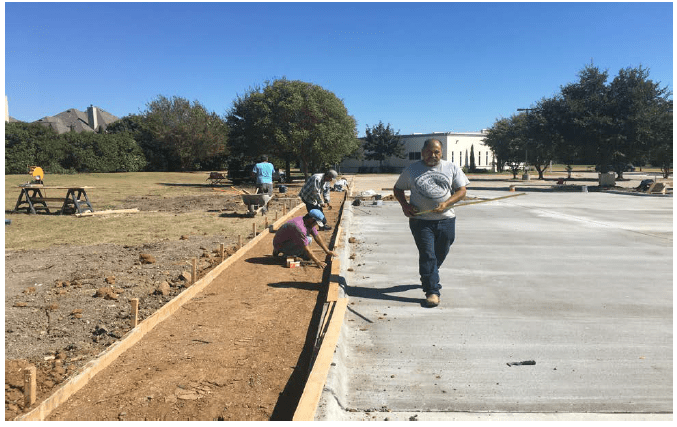

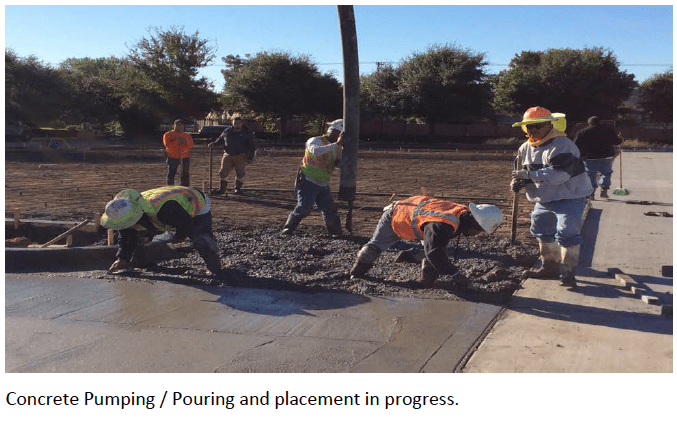

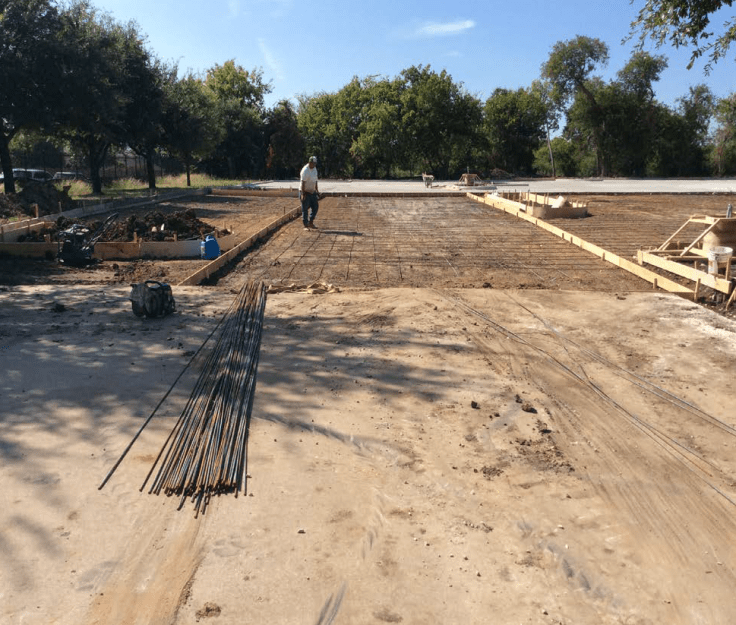

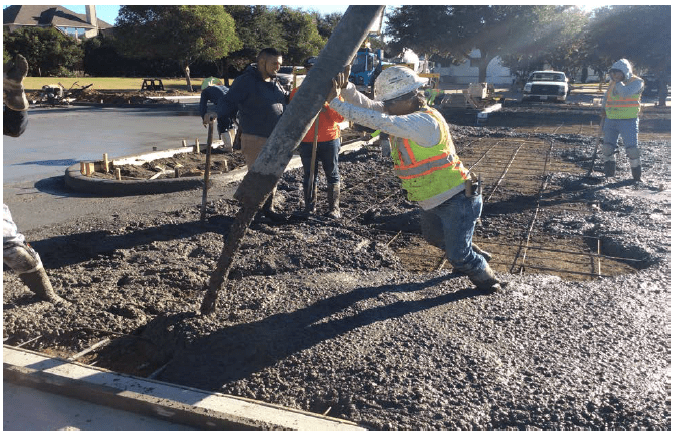

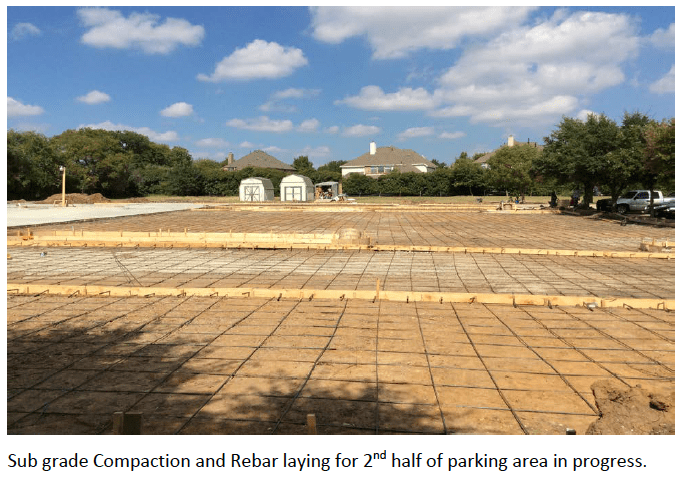

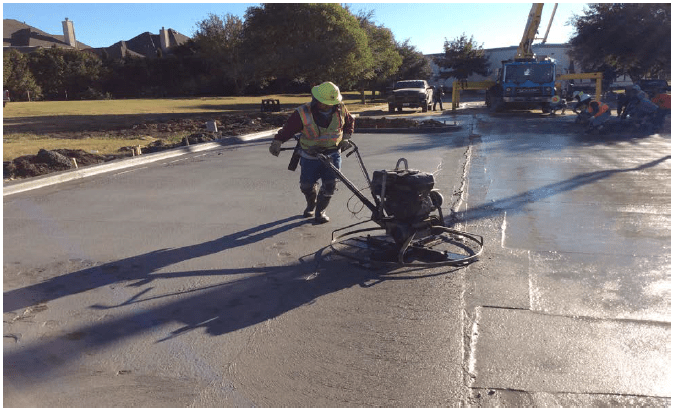

• The Second half of parking area concrete poured on Monday (10-16-17).

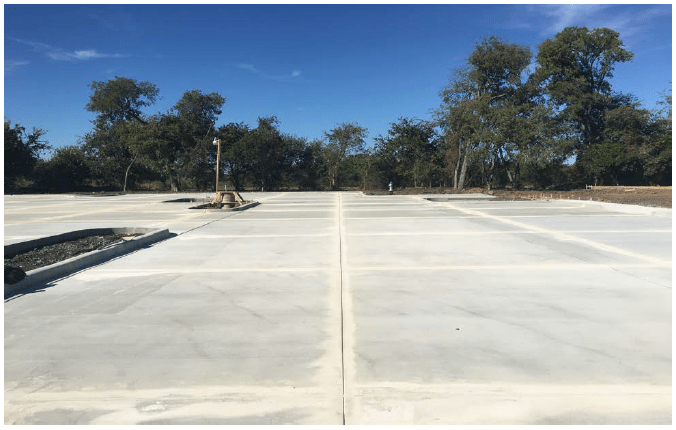

• Expansion joints and Vertical saw cut for concrete pavement of parking area are completed.

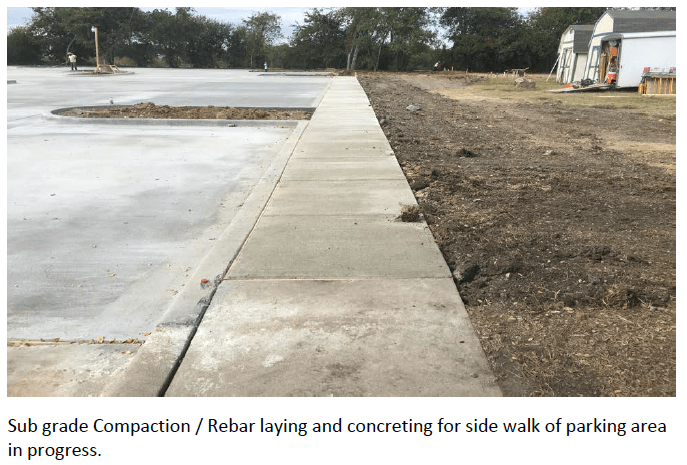

• Side walk at north side of parking area around 90 % completed.

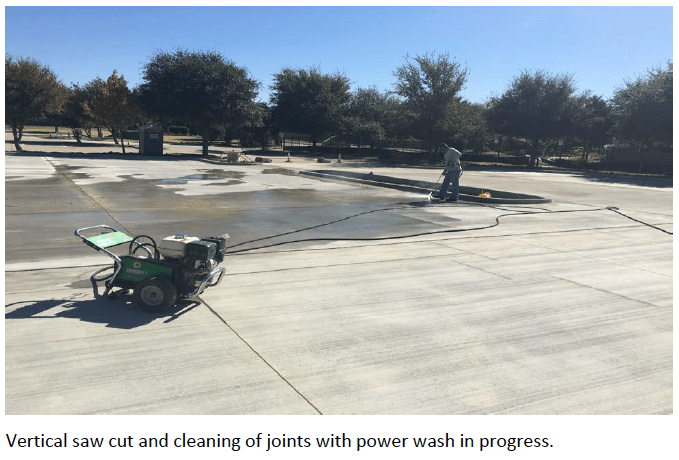

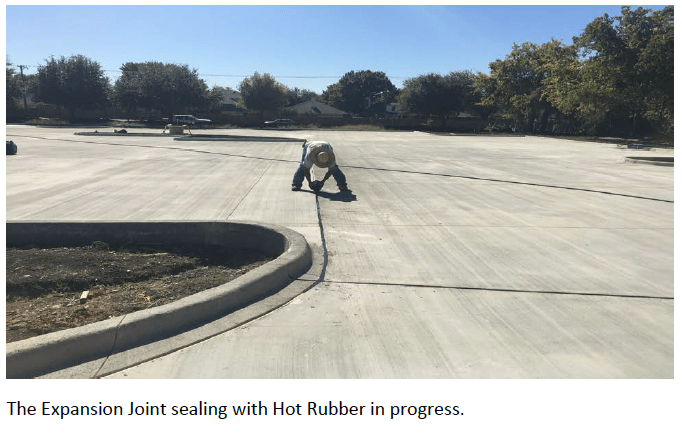

• The Expansion Joint sealing with Hot Rubber in progress.

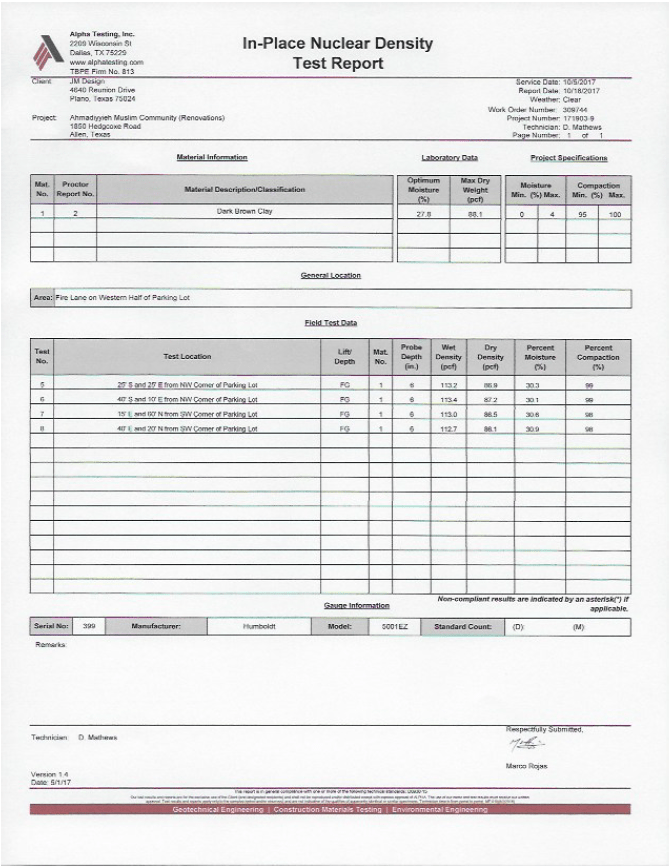

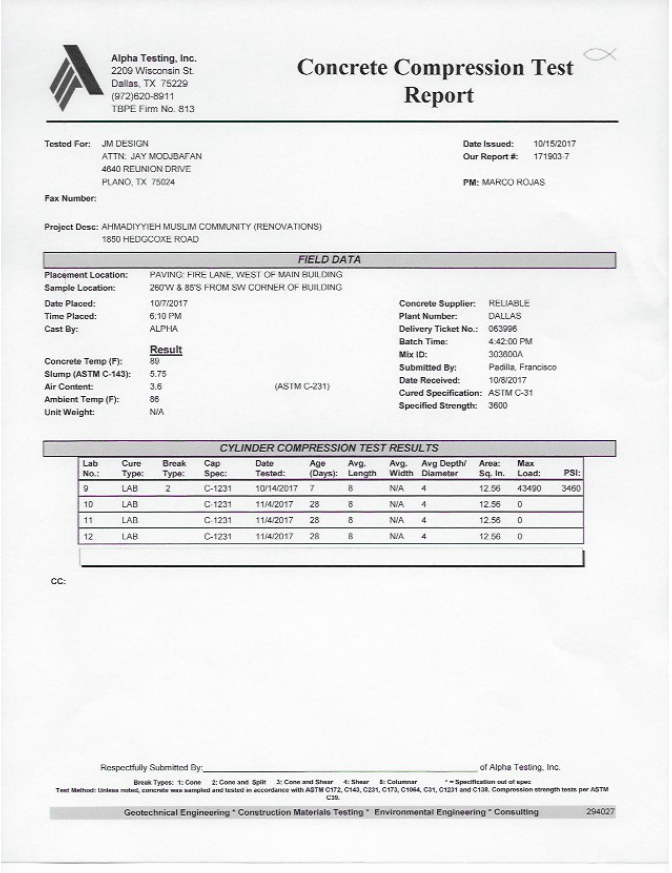

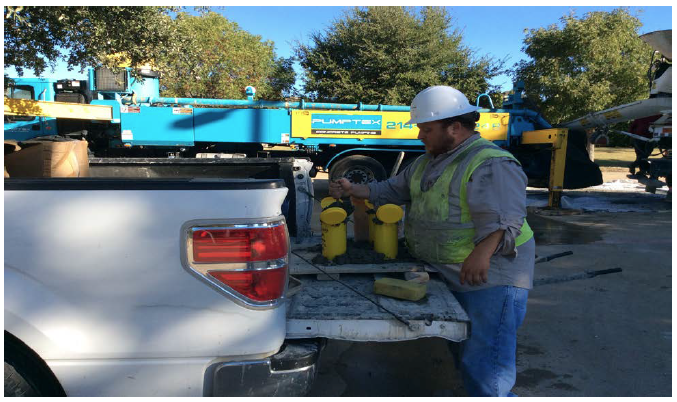

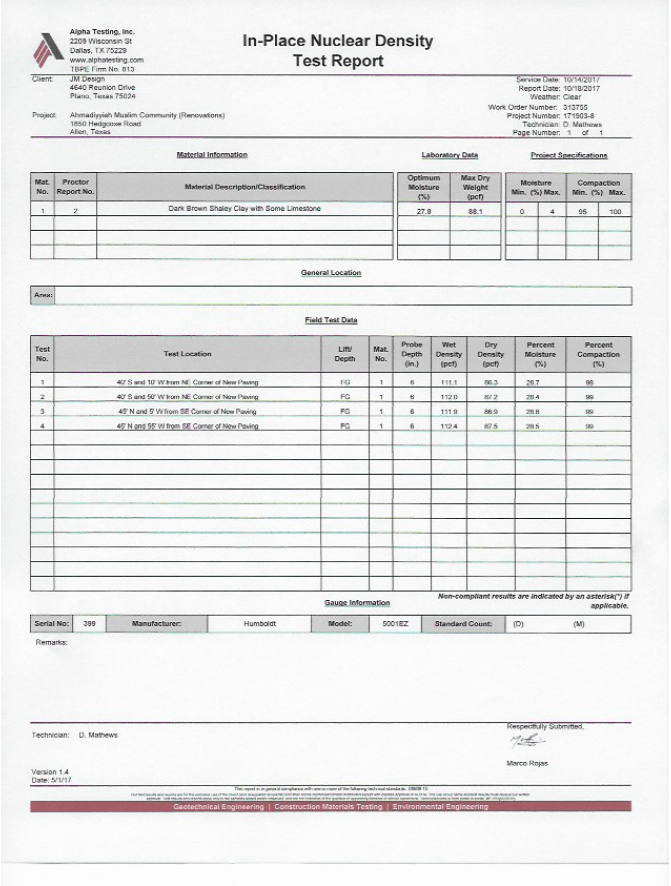

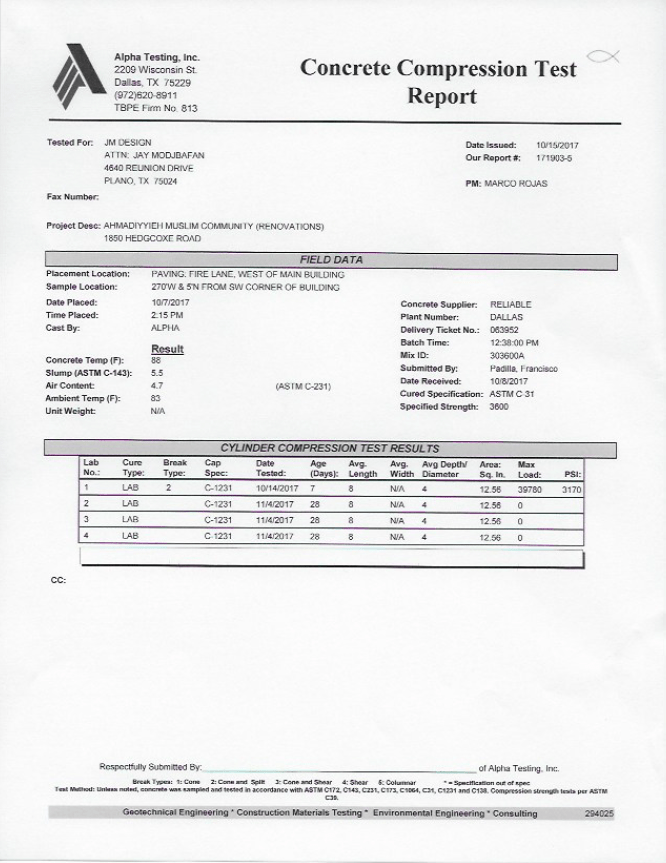

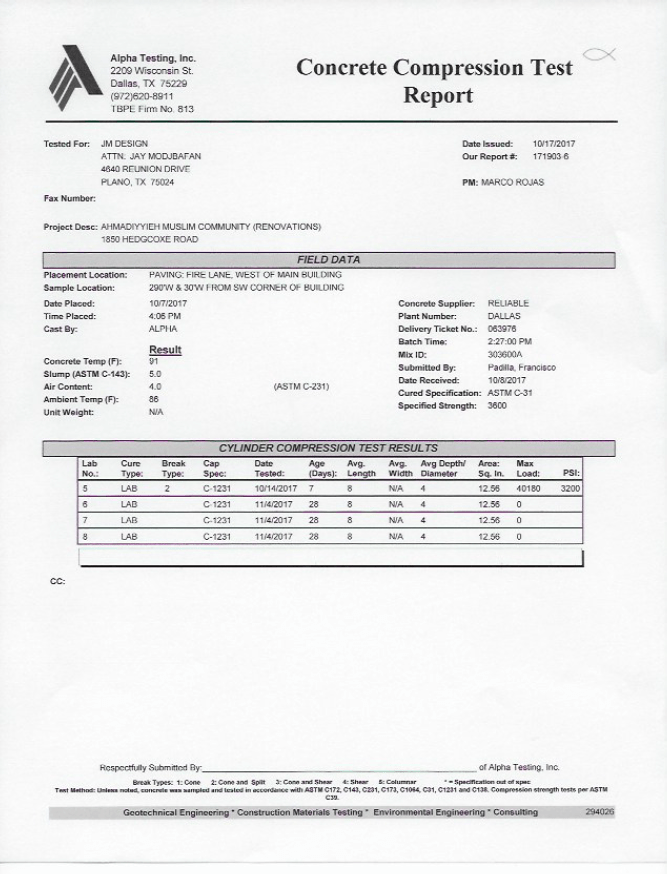

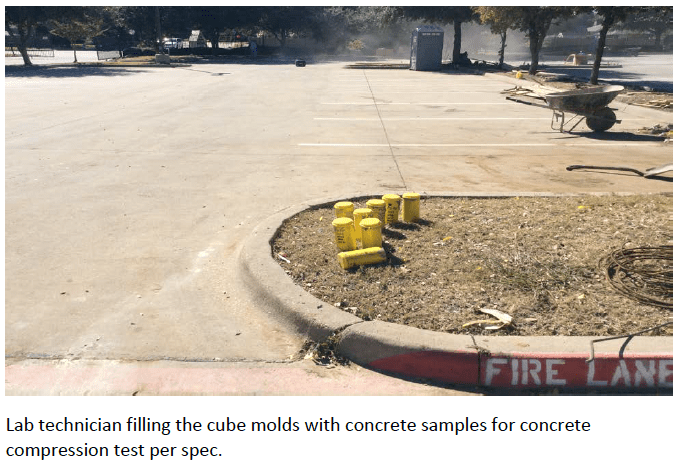

• Concrete Cubs crushing reports for parking area received and attached.
• GC (JM design) has planned to start Fire lane (Red) and Parking stripes (White) by next Week.
2. MASJID-A (NEW WORSHIP CENTER)
• Building permits under process.
3. EXISTING PRAYER HALL-B (FUTURE COMMUNITY HALL)
• Building permits under process.
4. NEW COMMERCIAL KITCHEN-C
• Building permits under process.
5. NEW MISSION HOUSE-D
• Building permits under process.

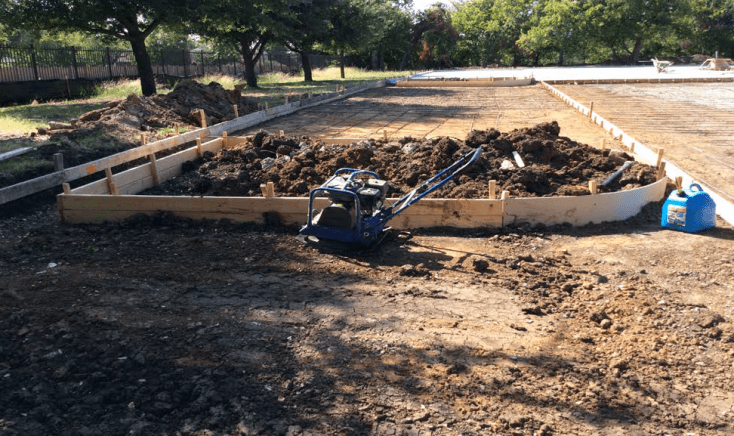

• The ground slab limit marked and grading under progress.
GENERAL NOTES:
• There is add on list of some small items forwarded to the contractor by the Jamat Vice president for pricing, Contractor is working on items price quote and will submit to the Client after Building permit approvals.
• Project Architect Mr. Ben Cortez came at site on Tuesday (10-24-17) to approve and verify the quantities of 2nd Application of payment.
• All buildings permit under approval process and Mr. Ben (Design Architect) working on new comments which were received from City of Allen officials by last week.
• The Contractor is requested to submit schedule of work.
JOB SITE PROGRESS:
